For organizations running workloads across AWS, Google Cloud, or Azure, this becomes more important as usage changes, teams adopt new services, and commitments alter the relationship between infrastructure usage and billed cost. A budget that ignores these factors can look accurate on paper while giving Finance, FinOps, and engineering teams the wrong signal.
This guide explains how to build a practical cloud budgeting process, and establish a recurring operating cadence. It also covers the budget capabilities and limitations of AWS, Google Cloud, and Azure, so you can apply the same budgeting discipline across a multi-cloud environment.
What is cloud budgeting?
To make that process work, teams need to distinguish between what they planned to spend, what they now expect to spend, and what they have actually spent.
- A budget is the approved spending plan.
- A forecast is the estimate of where spending will finish.
- Actuals are the costs recorded so far.

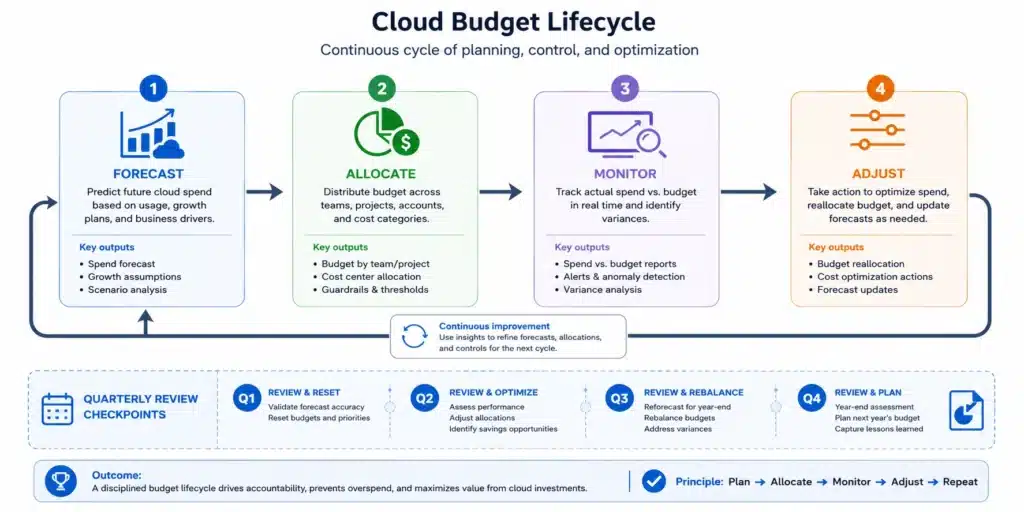

How to build a cloud budget
1. Establish a reliable baseline
Separate recurring production spend from temporary projects, migrations, experiments, and one-time purchases.

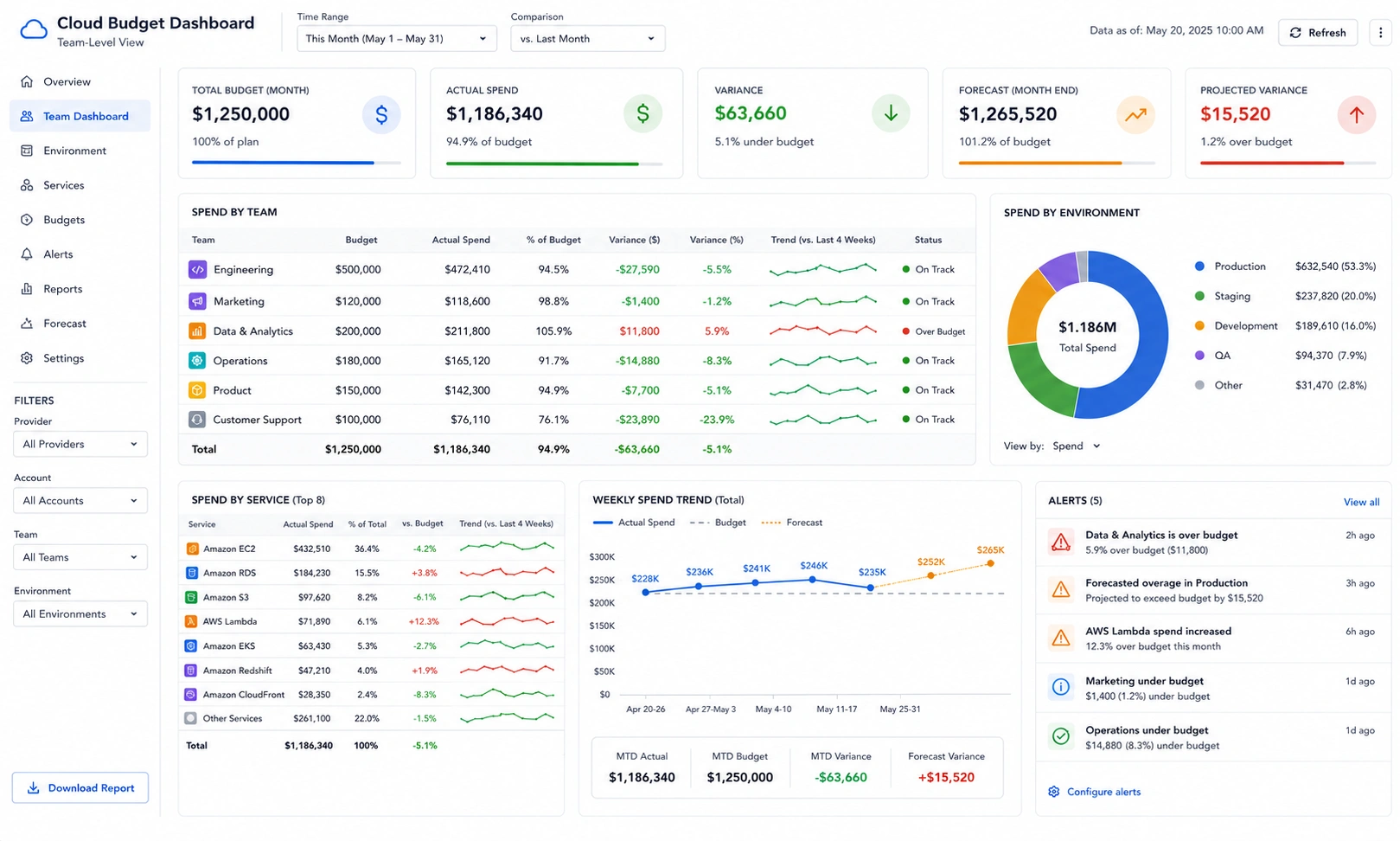

2. Define the budget scope
Choose a scope that maps to someone who can explain the spend and act when it changes.
3. Choose and document the cost basis
The key is consistency. Use the same cost basis when setting the budget, updating the forecast, and reviewing variance. Otherwise, a change in accounting treatment can look like a change in cloud consumption.
Also read: Understanding Savings Plan Amortized Cost in AWS Cost Explorer
4. Set the budget and variance thresholds
5. Assign an owner and review cadence
Then immediately follow it with the checklist:
Cloud budget setup checklist
Your budget, forecast, and variance reports should use a consistent basis so that changes in reported spend reflect real changes in cost.
Actual cost vs. amortized cost
So, for management reporting, choose one primary basis for budget, forecast, and variance reporting, while retaining a second view when Finance needs invoice reconciliation.
The important point is consistency. Do not compare an amortized forecast with a budget built from unadjusted invoice charges without explaining the difference.
Set thresholds and owners
For example, a team might investigate when the monthly forecast is more than 10% above budget, while a smaller variance may simply be monitored.
Assign an owner to each budget. For example, finance may own the financial target, while engineering or platform teams own the operational explanation and remediation. Shared ownership can be useful when the cause crosses organizational boundaries.
How commitments change the forecast
Consider a simplified AWS example where a workload normally generates $10,000 of monthly eligible On-Demand compute spend. The team purchases a Savings Plan with a $250 hourly commitment.

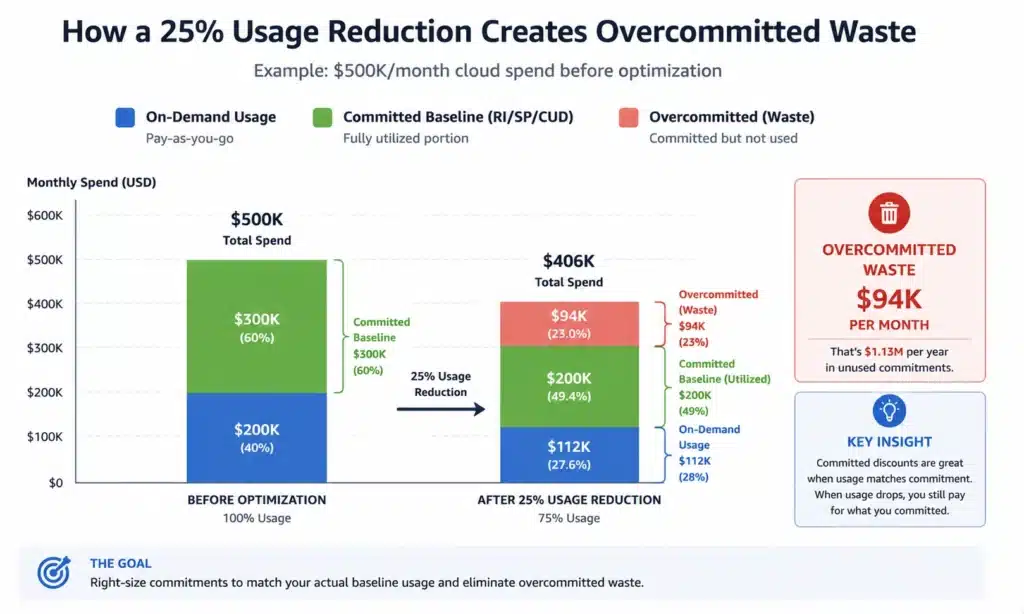

If the workload consistently uses less than the committed amount, some commitment can remain underutilized. If usage exceeds the committed level, excess eligible usage can still be charged at On-Demand rates.
The forecast therefore should not simply say “commitment purchased = $10,000 becomes $7,000.”
Instead, model the committed hourly amount, expected utilization, residual On-Demand usage, and any upfront or recurring commitment charges using the cost basis selected for reporting.
If the team later expects the workload to decline by 20%, that forecast change should trigger a commitment review as well as a budget review.
A simple monthly variance example
The owner should identify the driver. If $4,000 comes from expected customer growth and $2,000 comes from an unplanned workload, the actions are different.
Finance may approve a forecast update for the growth-related spend, while engineering investigates the unexpected workload.

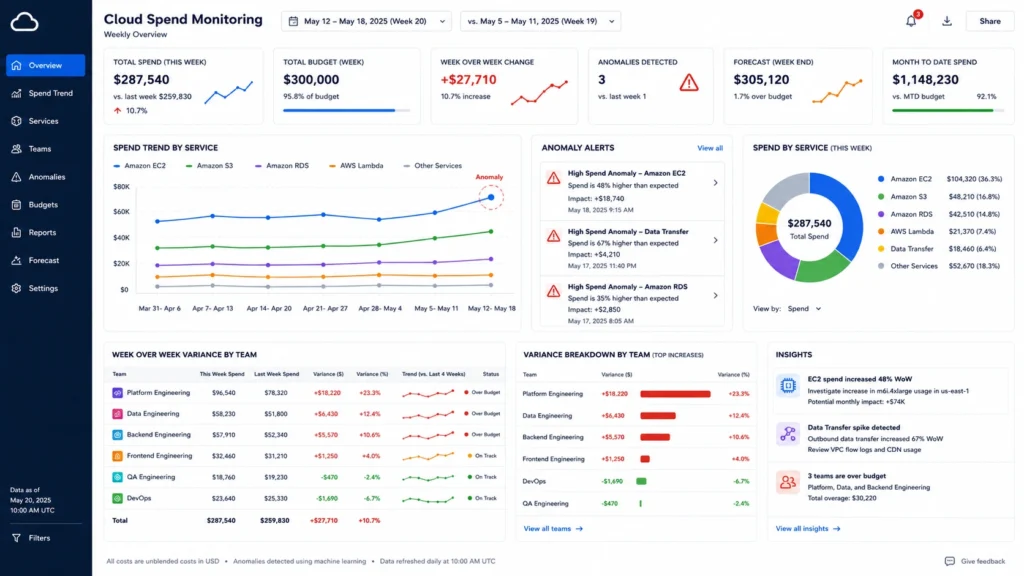

Monthly cloud-budget operating cadence
A useful budget process separates controllable cost increases from intentional growth, timing differences, and changes in the underlying plan.
This aligns with the FinOps Foundation’s budgeting guidance, which emphasizes ongoing planning, monitoring, variance management, and accountability.
How AWS, Azure, and Google Cloud budgets differ
| Provider | Budget capability | Important limitation |
|---|---|---|
| AWS | Cost and usage budgets, forecast alerts, and RI/Savings Plans tracking | AWS says Budgets information is updated up to three times daily. |
| Azure | Actual- and forecast-cost alerts with configurable thresholds | Cost data is typically available within 8–24 hours, and budgets are evaluated every 24 hours. Budgets do not stop resource consumption. |
| Google Cloud | Budget alerts plus programmatic notifications; eligible services can use Spend Caps in preview | Alerts-only budgets do not automatically cap usage. Spend Caps have separate eligibility and enforcement behavior. |

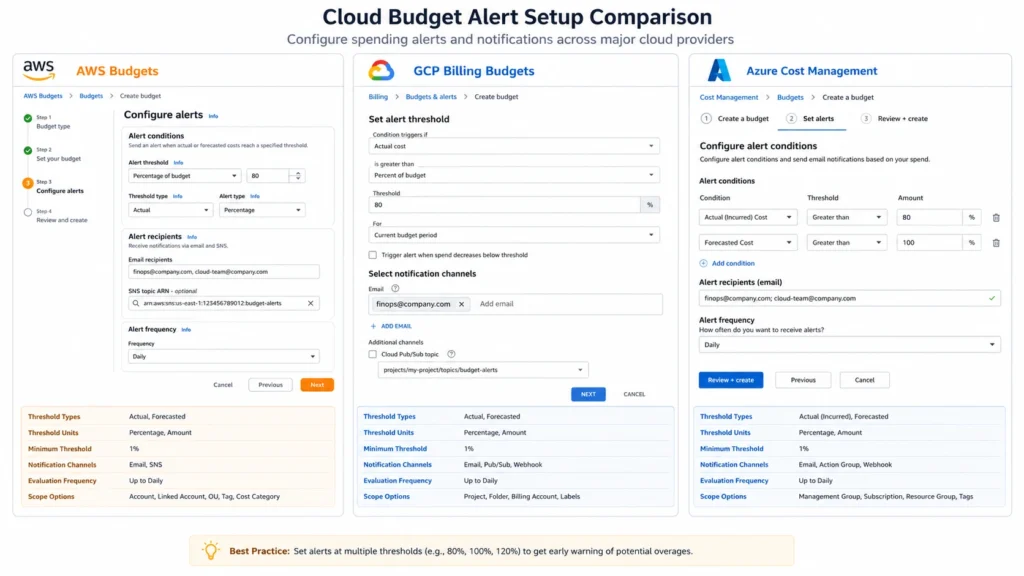

Budget alerts are not real-time guardrails
Use budgets alongside quotas, approval workflows, anomaly detection, and tested automation where interruption is acceptable. Any automated shutdown or restriction should be scoped, tested, and owned by a team that understands the operational consequences.
Also read: Multi-Cloud Savings Plan Strategy: AWS, Azure, and GCP Compared
Common cloud budgeting mistakes
- Budgeting only from last month’s bill: Historical spend is a baseline, not a forecast. Account for growth, seasonality, migrations, new services, and planned architecture changes.
- Mixing cost bases: Comparing actual invoice cost with an amortized forecast can create false variance. Document the reporting basis and keep it consistent.
- Treating alerts as controls: An alert tells someone that a threshold has been reached. It does not necessarily stop usage. Hard controls require separate mechanisms and careful testing.
- Ignoring commitments: A commitment can reduce the unit cost of eligible usage while introducing utilization and forecasting considerations.
- Assigning budgets without owners: A threshold without an accountable person becomes a notification rather than an operating control.
How Usage.ai fits
After a customer approves a recommendation, Usage.ai purchases and manages the commitment on their behalf.
Teams can achieve up to 50% savings on covered cloud spend, on average, without taking on the traditional commitment risk. Usage.ai charges a percentage of realized savings, and eligible commitments include cashback protection for underutilization.
The result is a managed commitment strategy that combines cloud discounts, automated management, flexibility, and protection, without replacing the infrastructure optimization work needed to make workloads efficient in the first place.
Make cloud spend predictable with better forecasts, commitments, and cost visibility.
Frequently asked questions
What is the difference between a cloud budget and a cloud forecast?
A budget is the approved spending plan. A forecast is the estimate of where spending is expected to finish. Comparing them helps teams identify material variance early.
Should cloud budgets use actual or amortized cost?
It depends on the reporting objective. Actual cost is useful for invoice and cash-spend reconciliation, while amortized cost can provide a clearer view of committed usage economics. The key is to document the basis and use it consistently.
Do AWS, Azure, and Google Cloud budgets stop spending?
Not by default. AWS and Azure budgets primarily provide monitoring and alerts, while Google Cloud alerts-only budgets do not automatically cap usage. Google Cloud also offers Spend Caps in preview for eligible services, with specific enforcement behavior.
How often should cloud budgets be reviewed?
Monthly is a practical minimum for many organizations, with more frequent monitoring for volatile workloads or material threshold breaches. The review should compare actuals, forecast, budget, and the drivers of significant variance.
Should commitments be included in a cloud budget?
Yes. The budget should reflect the organization's chosen cost basis and account for commitment purchases, covered usage, utilization, and residual On-Demand usage where relevant.
